Placement is the process of placing of all standard cells that are present in netlist by the tool into the core area.Tool also optimizes the design while placing. During placement trail routing also can be done by the tool. Placement can be done by the tool in 3 different techniques, which are
- Timing driven placement – Placement happens with timing as a priority
- Congestion driven placement – Placement happens with routing as a priority
- Power driven placement – Placement happens with power as a priority
Goals of placement
- Timing, area and power optimization
- Minimize congestion and congestion hotspots
- Minimum cell density, pin density
- No timing DRV’s
Inputs of placement
- Netlist
- Physical libraries (.lef)
- Floorplan DEF file
- MMMC (Multi Mode Multi Corner)
- Timing libraries (.lib)
- RC corners
- SDC file
- UPF file (if the design has multiple voltage domains)
Checks before placement
- Netlist should be clean.
- Floorplan DEF should be good
- Proper Pin placement
- Macros and pre-placed cells should be in fix.
- Power routes should be free of DRCs
- Check for don’t use, don’t touch cells and routes should be applied properly.
Placement steps
Placement has many steps, so, let us divide all the steps into 3 parts:
Preplacement
⇓
Placement
⇓
Post placement
Pre-placement
- During this step all the pre-placement checks have to do.
- If everything is clean then all the required pre-placement cellshave to place (Like Endcap, Well Tap, Spare cells, Decap cells etc.…).
Note: We have already explained all pre-place cells in Physical only cells topic.
Placement
Now, during placement mainly 3 steps can be done, which are discussed below:
- Global placement
- Early global routing
- Legalization
- High Fanout Net Synthesis (HFNS)
- Scan chain reordering
Global Placement
During global placement, tool places all the standard cells into the core area. As you read already in the placement definition, tool follows different types of techniques to place standard cells into the core area. In this step, tool will not follow any DRCs (like standard cells overlapping, miss alignment to the std cell rows) and creates more density areas following figure shows the global placement. Trail routing also can be done by the tool after one global placement iteration.
Trail Routing or Early Global routing
During placement stage tool do trail route along with placement of standard cells.During trail routing tool divides entire metal layer into number of GCells. Each GCell carries set of horizontal & vertical routing tracks following figure shows the example of GCells. By using those GCells tool do quick routing to estimate routing related congestion and net parasitic (resistance and capacitance) values for optimization and timing analysis.
In the above figure you can see a vertical metal layer. Entire layer can be divided into 16 GCells and each GCell have 5 routing tracks.
What is congestion?
When the number of routing tracks available for routing in a given location is less than the number necessary, the area is considered congested and hence, it is termed as routing congestion.
Congestion=Available routing tracks – Required routing tracks
Note: The result should be 0 (zero) or greater than 0(zero). If you are getting negative value that means you have congestion.
In the above figure you can see congestion occurred in metal track 3. Where that track is already used to connect standard cells C and D from that same track another route is connected to A and B. So, here tool used already routed track to complete the routing. Hence congestion occurs .Trail routing almost meets 95% of final routing criteria. After trail routing completed, if the congestion is in acceptable range then we can proceed to next step. Usually acceptable congestion value is 0.2% without hotspots. Here, hotspots mean if all the neighboring Gcells are congested then it is called as hotspot.
Legalization
During legalization tool tries to spread the standard cells. If the cell density is more in a particular area in order to get rid of power issues, tool will distributes the cells. In this step the tool exactly aligns all the overlapped standard cells into standard cell rows by following DRC rules and it makes sure that there are no standard cells placed out of the core area. The following figure shows after legalization step performed by the tool.
High Fanout Net Synthesis
Some of the nets will have very high number of fanouts like Reset, Scan Enable etc… But, there is a restriction for maximum fanout in timing constrains.Even though it is a soft constraint high fanout will increase load capacitance. Based on the fanout constraints tool identifies the high fanout nets in the design. Then tool optimizes these nets by picking the right drivers or adding buffers to drive the load, adding repeaters to reduce on delay and signal integrity, and balancing the net’s capacitance and resistance to strengthen the signal integrity. By doing optimization tool meet the signal quality and timing requirements of the design while minimizing delay, power consumption, and noise on high fanout nets. Following figure shows an example for HFNS.
Let’s consider the max fanout constraint is ‘7’ for this design. But in the above figure before HFNS, on the RESET port have 21 fanout, so, tool identifies this reset port net and do optimization by buffering. So, tool added 3 buffers and at each buffer output tool connected 7 cells to meet the fanout constraint.
Scan chain reordering

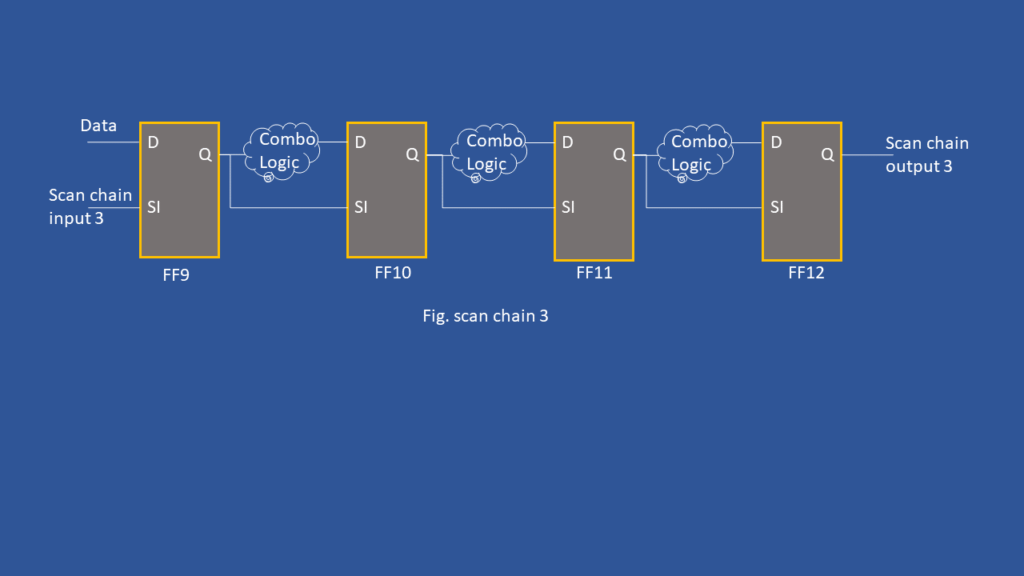

During the DFT stage, all the flipflops are connects in the form of shift registers pattern like the circuit shown in below image.
DFT team create multiple scan chains like the diagram shown above. They divide all available flipflops in the design into equal number of sets and stitches scan chain. Each set represents one scan chain. For example, consider a design have 12 flipflops then DFT team creates 3 scan chains, each chain will contain 4 flops and all are connected to each other in shift registers pattern.
After placement, all the flipflops are placed into core area and there will be some distance in between the flops. to complete routing below figure shows an example.
So, which scan chain reordering tool deletes all existing scan chain routes and creates a fresh scan chain routes by connecting the flops which are near to each other. There is no requirement to check the flops are functionally talking or not for scan chains.
Note: functional routes are not like scan chain, for functional routes FF1 output have to must connect input of FF2, FF2 output to FF3 input and go on.
Post placement
- During post placement tool tries to meet all design timing requirements like DRVs then WNS (Worst Negative Slack) and TNS (Total Negative Slack) only for setup slack.
- Finally tie cells also can be placed by the tool for the required input pins.
